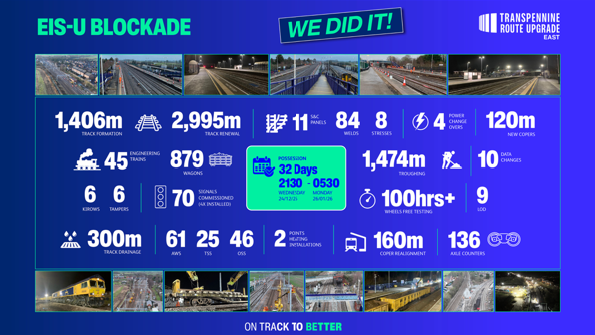

Helping deliver faster, greener, more frequent services across the North The Transpennine Route Upgrade (TRU) East of Leeds Alliance has delivered a significant package of improvements between Leeds and York, helping deliver faster, greener, more frequent services across the North. Following more than a year of planning, collaboration and preparation, the Entry into Service (EiS) U blockade has been successfully completed, after a successful 32 day blockade. This programme represents one of the largest and most complex pieces of work delivered by the TRU East Alliance, comprised of VolkerRail, Network Rail, Murphy, Siemens Mobility, and SYSTRA. The majority of the infrastructure re-modelling took place in and around the Church Fenton, with the blockade delivering two key EiS milestones: Stage 1: The culmination of two years of rail systems improvements. Within the first 100 hours, teams installed 17 kilometres of lineside containment and bases, creating a new route for low voltage power distribution, new signalling systems and new telecoms cables. These systems were commissioned into use between Leeds and Church Fenton, including new data and screen changes at York’s Regional Operations Centre, where the new signalling system will be controlled. Stage 2: The remainder of the blockade focused on re-modelling the infrastructure including 3km of track, eleven switches and crossings, 70 new signals, major earthworks and platform modifications to enable future line speed increases. Ahead of the blockade, the installation of Rose Lane Bridge and Barrowby Bridleway Bridge marked significant enabling milestones. These structures allowed eight level crossings/user works crossings in the surrounding area to be closed, delivering significant safety improvements and providing safer routes for pedestrians and vehicles to cross the railway. Jamie Rothwell, transportation managing director at Murphy, said: “This latest project milestone demonstrates the truly collaborative nature of the TRU East Alliance. At Murphy we are proud to have played our part in successfully completing this blockade and look forward to continuing to work together on upgrades in order to deliver faster, greener, more reliable train services between York, Leeds and Manchester. James Richardson, TRU managing director, said: “It’s great to have completed these critical railway upgrades, between Leeds and York. Facing all weathers, our teams worked around the clock during the Christmas period and through January, delivering a host of improvements for passengers, safely and on time. “Our work highlights the impact we are making in transforming the railway in the North of England, helping to enable economic growth, while building future capability for major projects.” This successful delivery reflects the collective effort of everyone involved, from on-site teams and support functions to those who played a critical role in planning, assurance and coordination. HIGHLIGHTS Successful 32 day blockade following a year of planning Within the first 100 hours, teams installed 17 kilometres of lineside containment and bases Major infrastructure re-modelling including 3km of track, 70 new signals, major earthworks and platform modifications
